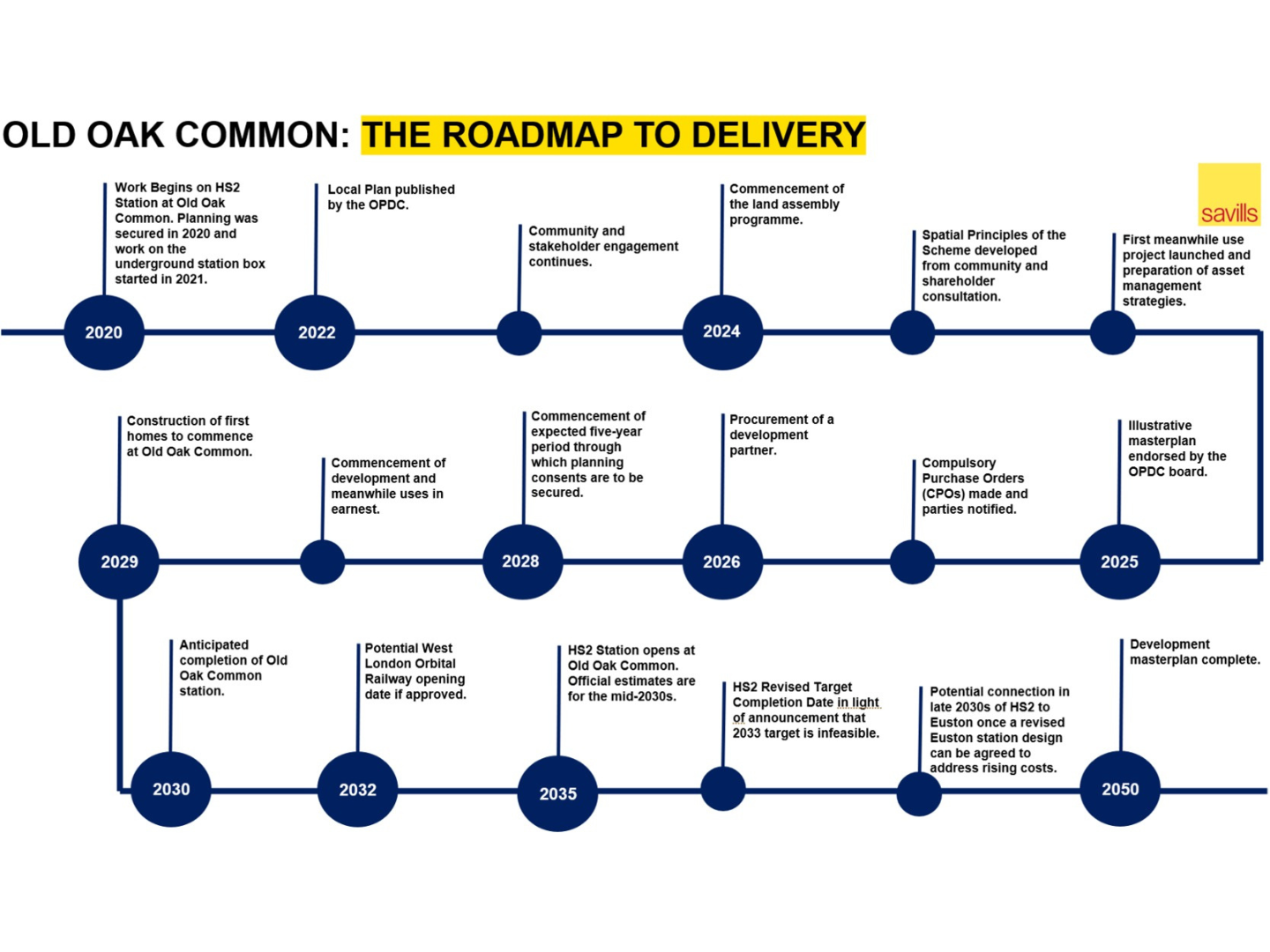

Figure 13: A Timeline of Key Development Milestones at Old Oak Common. Created With Reference to Mayor of London & OPDC (2025a).

As shown in Figure 13, significant progress has already been made in the transformation of the area and construction of Old Oak Common station in particular, which secured planning in 2020 and has completed excavation of the 20-metre-deep underground station box to enable current work on the high-speed platforms⁴⁹.
At present, the key process of land assembly is underway, set to be facilitated by the CPO process of which formal notice was given in September 2025⁵⁰. The complication and expense of this process, although still significant, is greatly reduced by over 90% of land required for initial redevelopment proposals being in public ownership.
Additionally, the first meanwhile use has already begun, with OPDC’s Minerva Works scheme opening in the heart of Park Royal to house a group of local enterprises focused on the circular economy⁵¹. Specifically, Minerva Works is seeking to reuse waste materials from businesses in Park Royal and the nearby HS2 Development, including the clay extracted in the construction of Old Oak Common station, with a total aim of creating 35 jobs and salvaging 20 tonnes of otherwise wasted materials – saving 28 tonnes of carbon - over the scheme’s lifespan⁵².
The next steps towards delivery involve negotiating a public land agreement with the Department for Transport and Network Rail following the presentation of the outline business case. Once this is completed, the OPDC can begin work on selecting a JV partner bring the long-awaited masterplan forwards.
Key dates remaining in the delivery process include the construction of the first homes, slated to commence in 2029⁵³, the completion of Old Oak Common station in 2030, and the arrival of HS2 Phase 1 (Old Oak Common to Birmingham). The latter has been subject to review, with both Transport Secretary Heidi Alexander and HS2 Ltd CEO Mark Wild admitting that the initial 2033 deadline is now infeasible⁵⁴, precipitating a £25.3bn government funding packing for 2026-2030 in a bid to form a new business plan targeting cost limitation and certainty on timescales, which is still yet to be provided⁵⁵. Should it gain approval, The West London Orbital Railway is estimated to complete in the mid-2030s, providing commuters from across West London in areas such as Brent Cross, Brentford and Hounslow better access to the underground system, and subsequently Central London, via the Elizabeth Line from Old Oak Common⁵⁶.
Beyond this, the HS2 station at Old Oak Common is expected to be fully operational by 2035 and when coupled together with the welcome news of the Old Oak to Euston tunnel commencing construction in January, it is anticipated that this vital link to Central London will be operational around 2040.
Ultimately, the OPDC are leaving no stone unturned in their bid to drive this compelling regeneration forwards and ensure that Old Oak capitalises on its strategic location surrounding London’s first major new transport intersection to deliver a new community predicated on sustainability, community and innovation and opportunity for West London.
